Skip to content
Image from Power Plant Outage Mechanical Repairs at Jackson Generation in Elwood, IL

PROJECTS

Power Plant Outage Mechanical Repairs at Jackson Generation in Elwood, IL

Planned Outage Mechanical Repairs Across Units 1 and 2

Project

Mechanical Equipment & Piping Installation

Services

ASME Code Welding Services in Illinois

Date

May 2025

Location

Elwood, Illinois

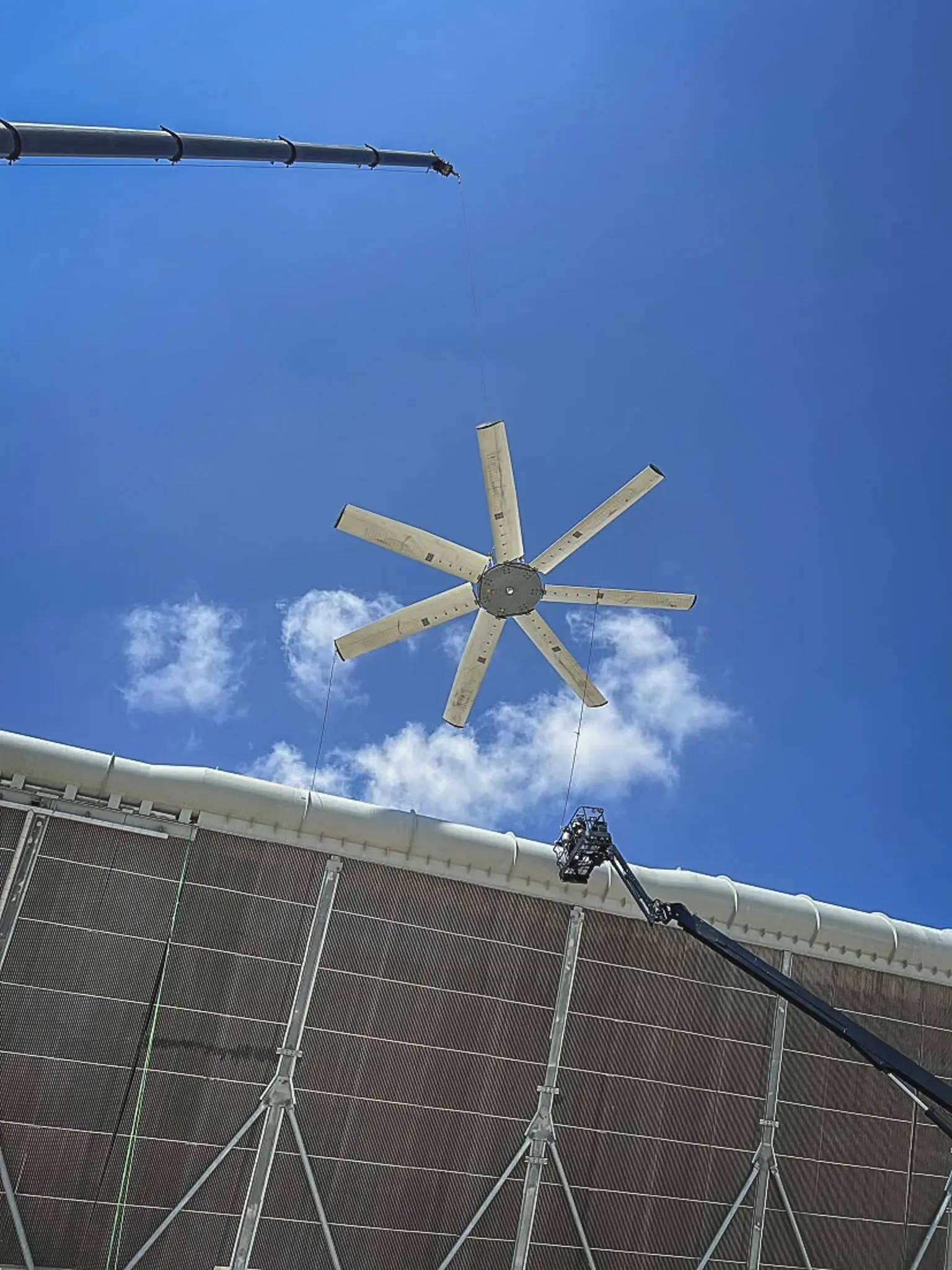

crane lift of fan blades

Project Overview

Multi-Trade Mechanical Repairs During a 15-Day Power Plant Outage

DePue Mechanical supported a planned shutdown at Jackson Generation, a 1,200 MW natural gas-fueled combined-cycle power generation facility in Elwood, Illinois. The outage ran from May 3 through May 17 and required coordinated shutdown and turnaround support across Units 1 and 2.

The work ranged from heavy equipment lifts and air-cooled condenser gearbox replacements to pressure piping welding, valve and thermowell installations, confined-space repairs, HRSG work, gasket replacement, and SCR blower valve replacement.

Completing this scope required multiple work fronts to advance in parallel. Crane operations, gearbox work, radiographic testing, post-weld heat treatment, off-site machining, vessel entries, and round-the-clock welding all had to be coordinated within the same fixed outage window.

Project Challenge

Completing Critical Repairs Across Two Units Without Extending the Outage

The client needed one mechanical contractor capable of managing a varied list of outage repairs across both generating units. The work included rotating equipment, heavy lifts, specialty alloy pressure piping welding, nondestructive examination, heat treatment, confined-space entries, instrumentation connections, large-diameter gasket and expansion joint replacements, and leak repairs.

Several activities also depended on outside inspection or support services. The 9-chrome valve replacement required radiographic testing before and after post-weld heat treatment. Drum doors had to be removed, sent out for machining, returned, and reinstalled. Gearbox replacements required crane access and a carefully controlled removal and reassembly sequence.

For the plant team, the main concern was not simply whether each individual task could be completed. The entire scope had to be sequenced so crane work, inspections, confined-space operations, machining, and mechanical repairs did not interfere with one another or jeopardize the end of the outage.

Outage Scope

Mechanical Maintenance and Repairs Across Units 1 and 2


DePue performed the following work during the scheduled shutdown:




  • Replaced four ACC gearboxes, with two changeouts on each unit

  • Drained and replaced oil in 48 ACC gearboxes

  • Removed and reinstalled IP and LP drum doors for machining

  • Replaced a 2-inch 9-chrome valve

  • Coordinated four radiographic examinations and post-weld heat treatment

  • Replaced small-bore socket-weld valves

  • Installed a stainless o-let and thermowell on the RO water system

  • Replaced a 48-inch condenser strainer gasket

  • Replaced a failed Unit 1 IP turbine thermowell

  • Installed screens on HP, IP, and LP vessel vortex piping

  • Repaired an HRSG drain damaged during cold weather

  • Repaired a leaking lube oil accumulator fitting

  • Welded 144 tube-abandonment plates from inside 48-inch ACC piping

  • Replaced a 24-inch expansion joint

  • Installed new mesh and clips inside the Unit 1 and Unit 2 HP drums

  • Replaced a 16-inch butterfly valve on the Unit 2 SCR blower

Gearbox Replacement and Crane Work

Four ACC Gearbox Changeouts Using a 125-Ton Crane

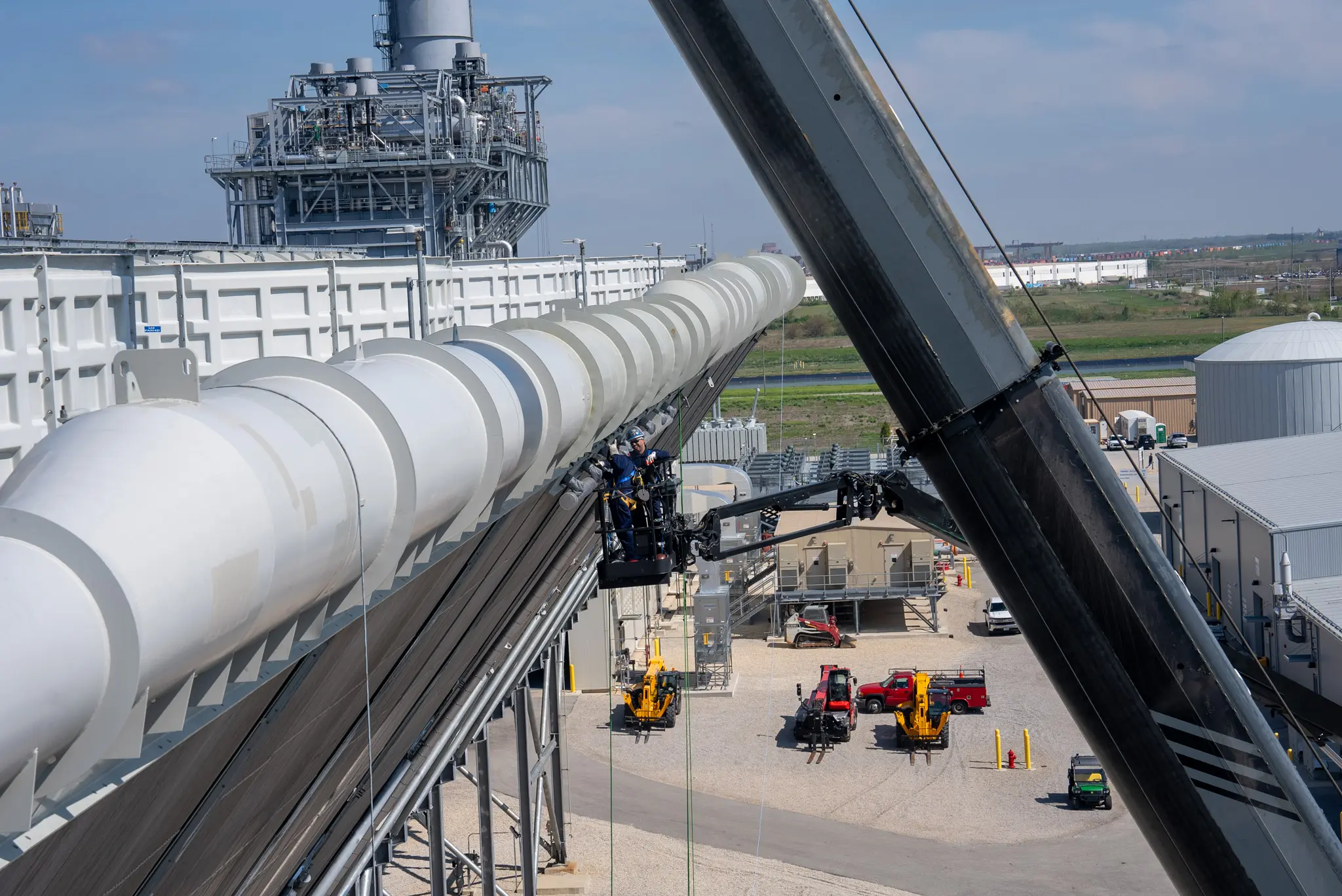

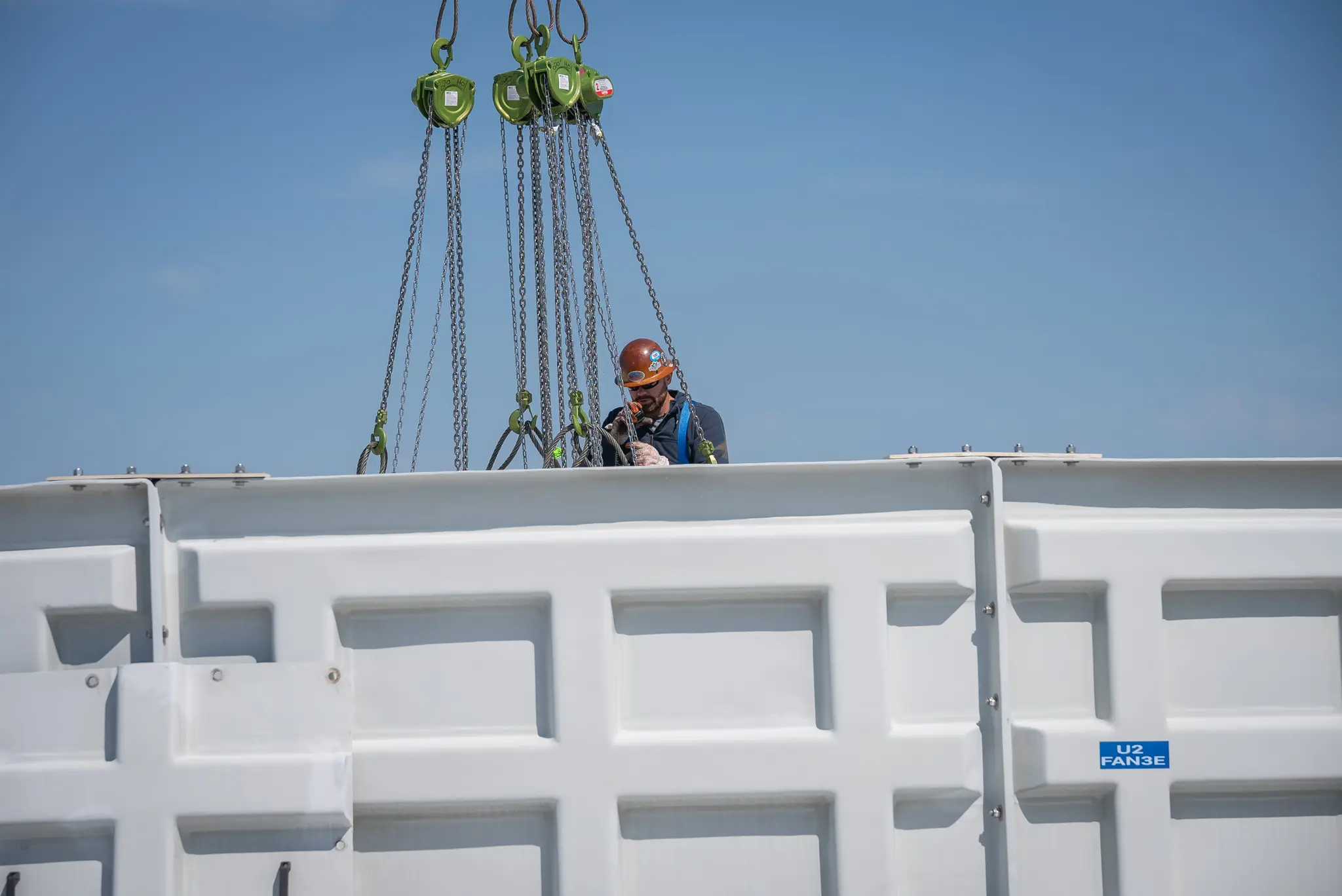

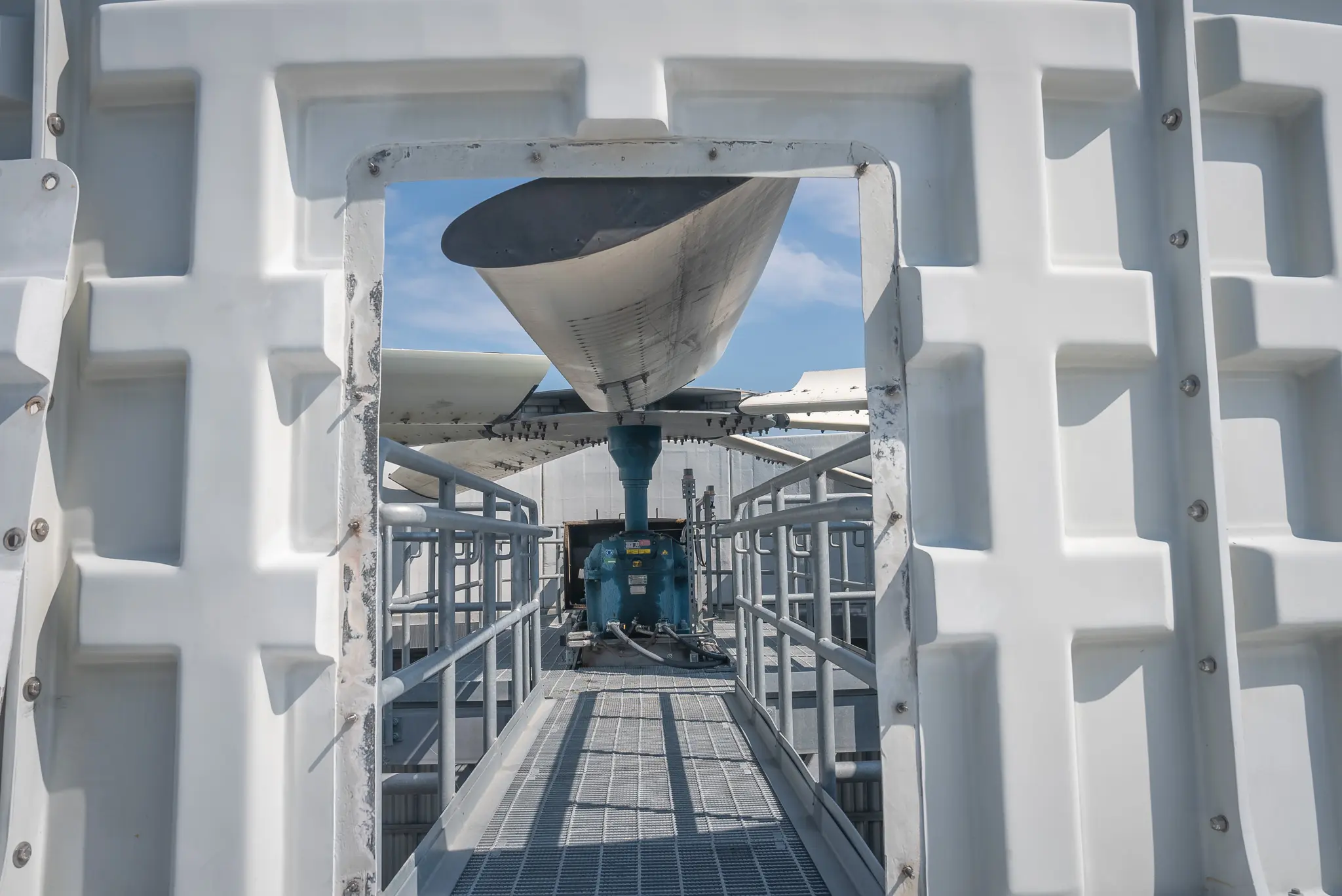

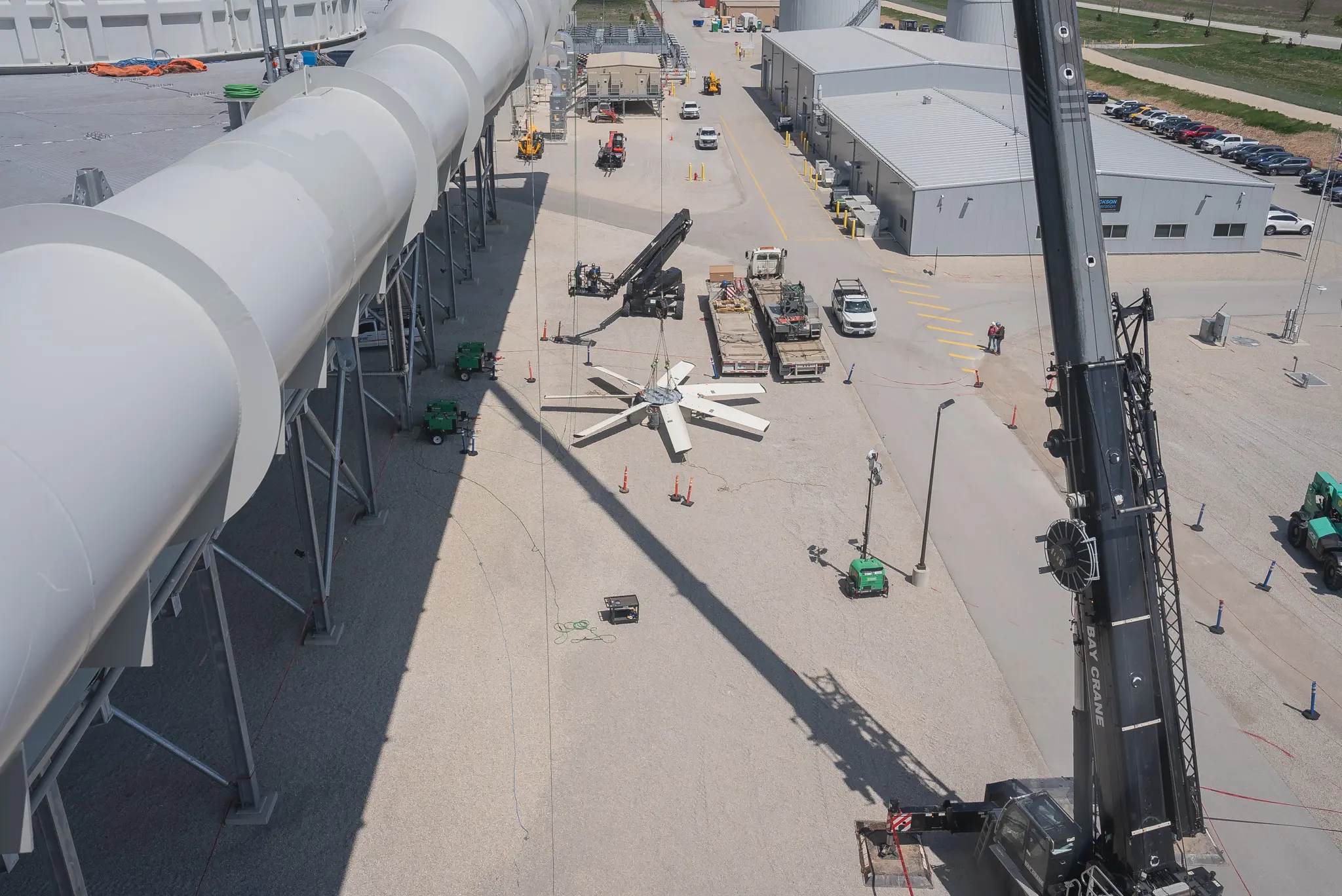

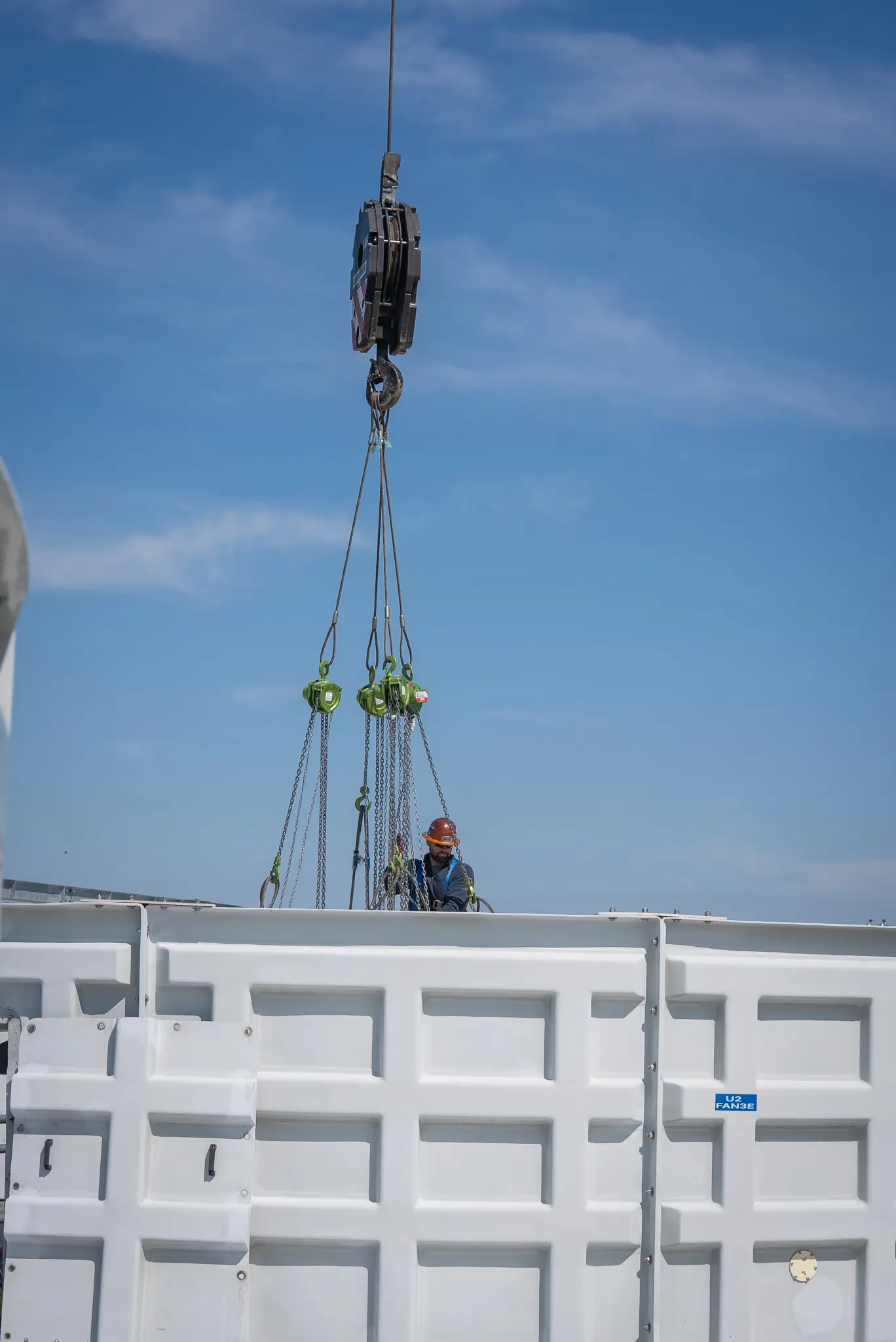

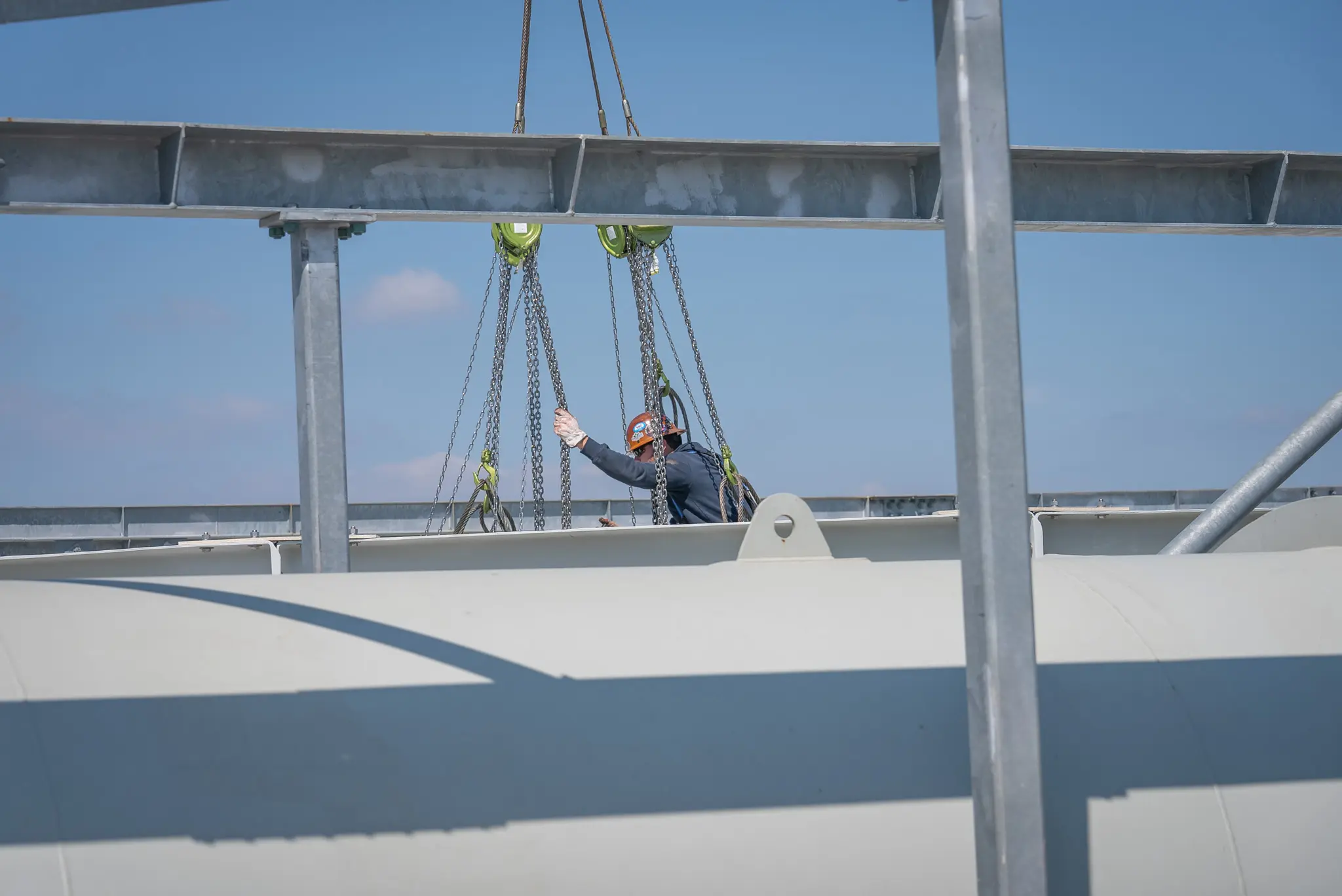

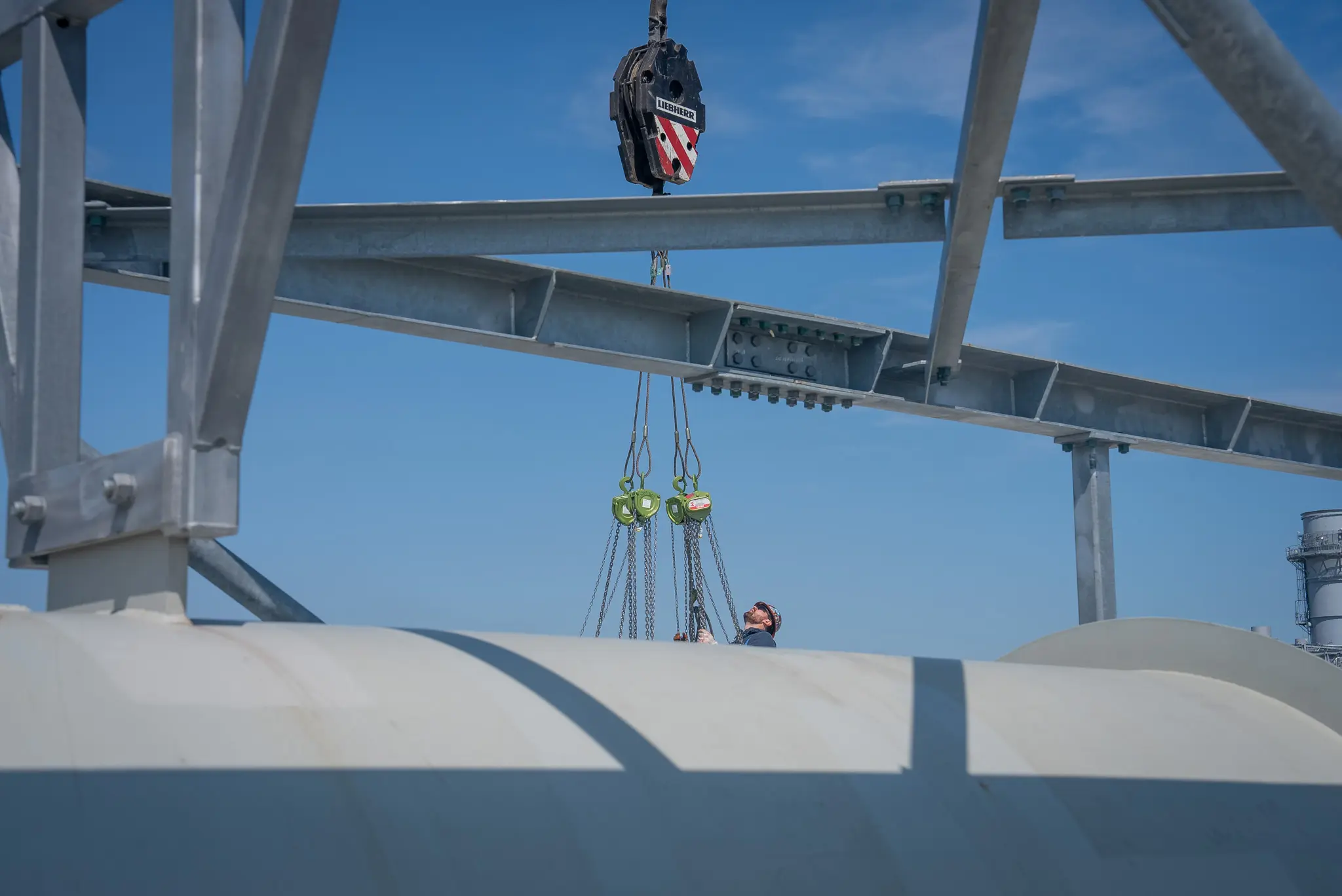

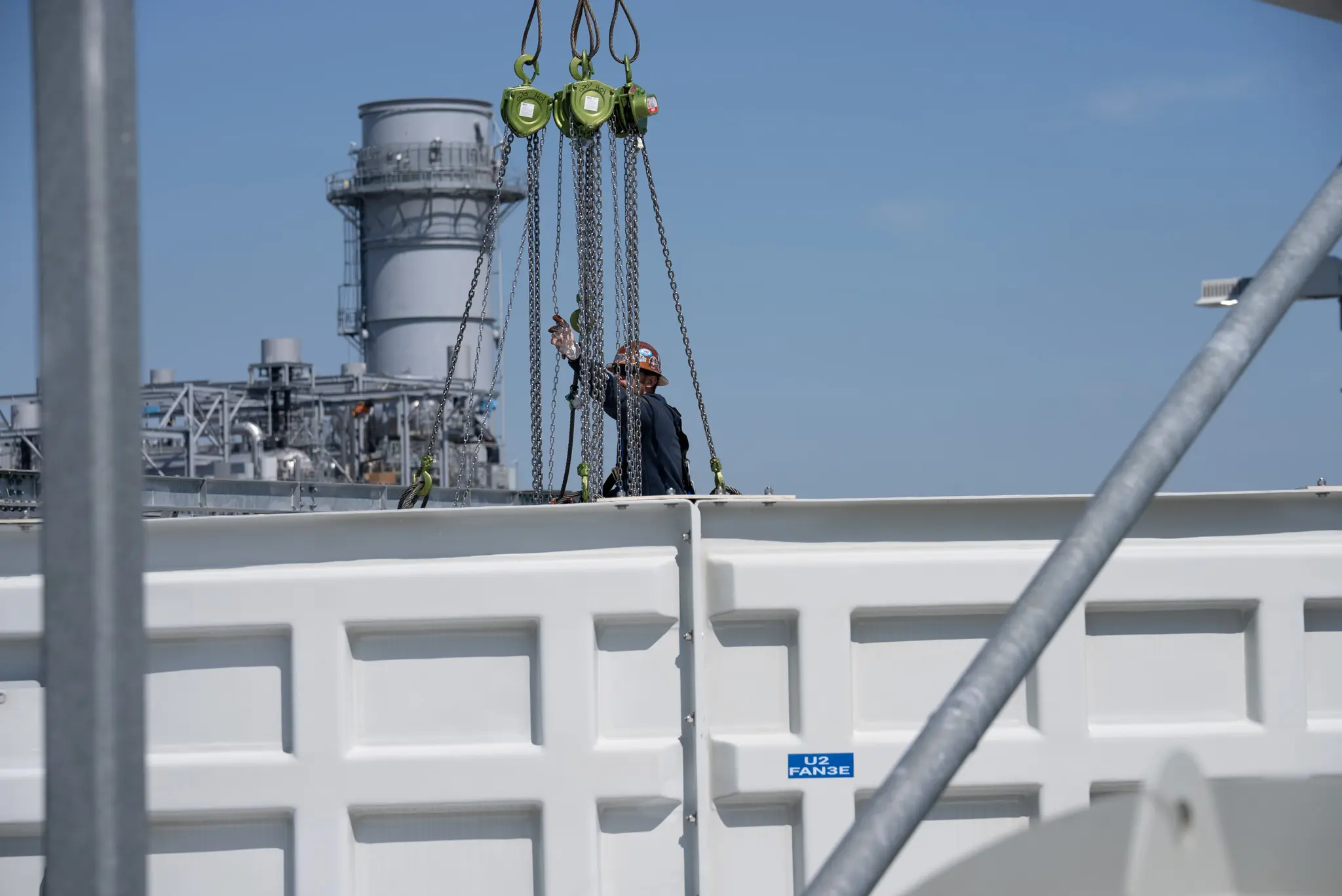

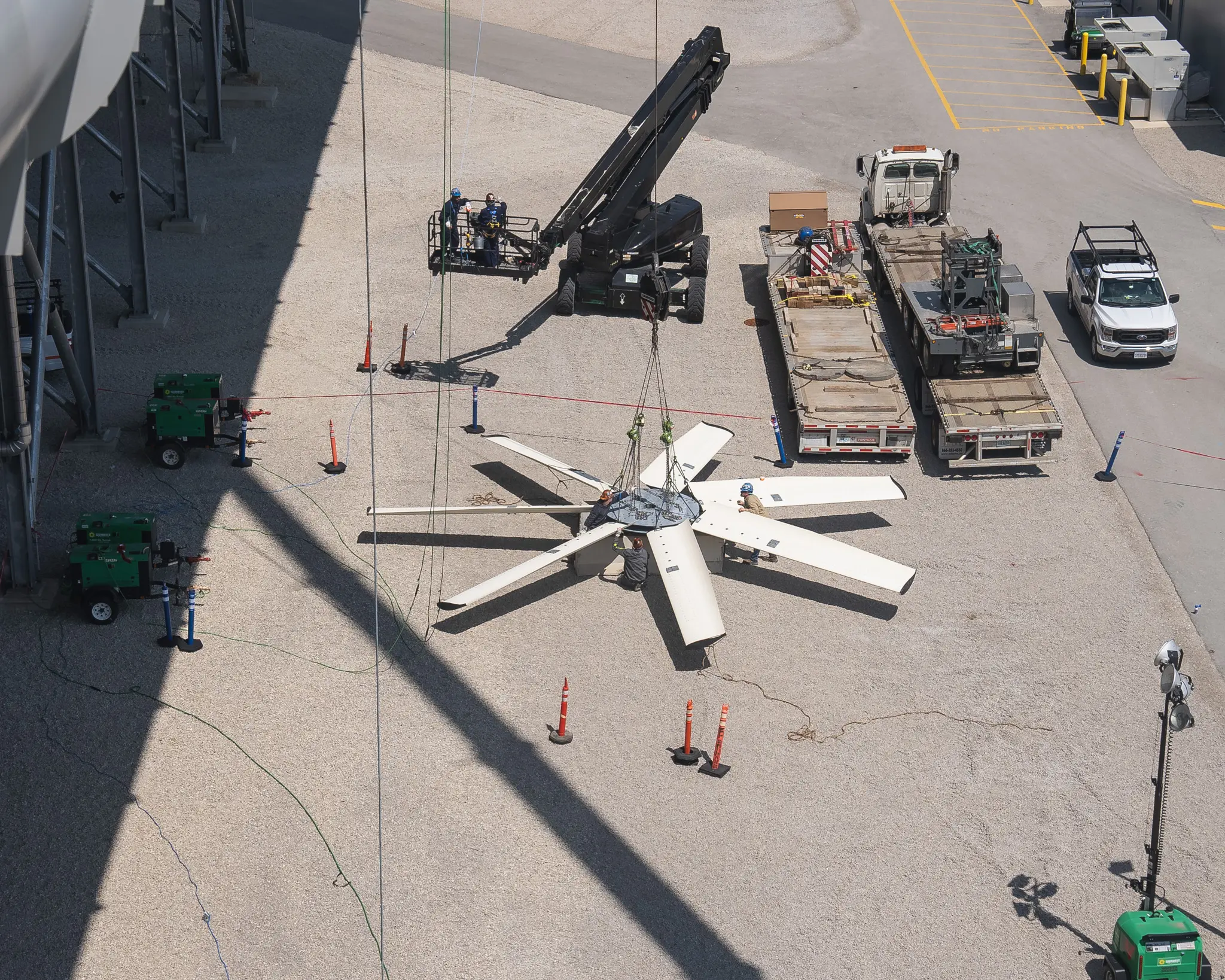

DePue replaced four air-cooled condenser gearboxes, with two gearboxes changed on each unit, as part of a coordinated heavy equipment setting and crane lift scope.

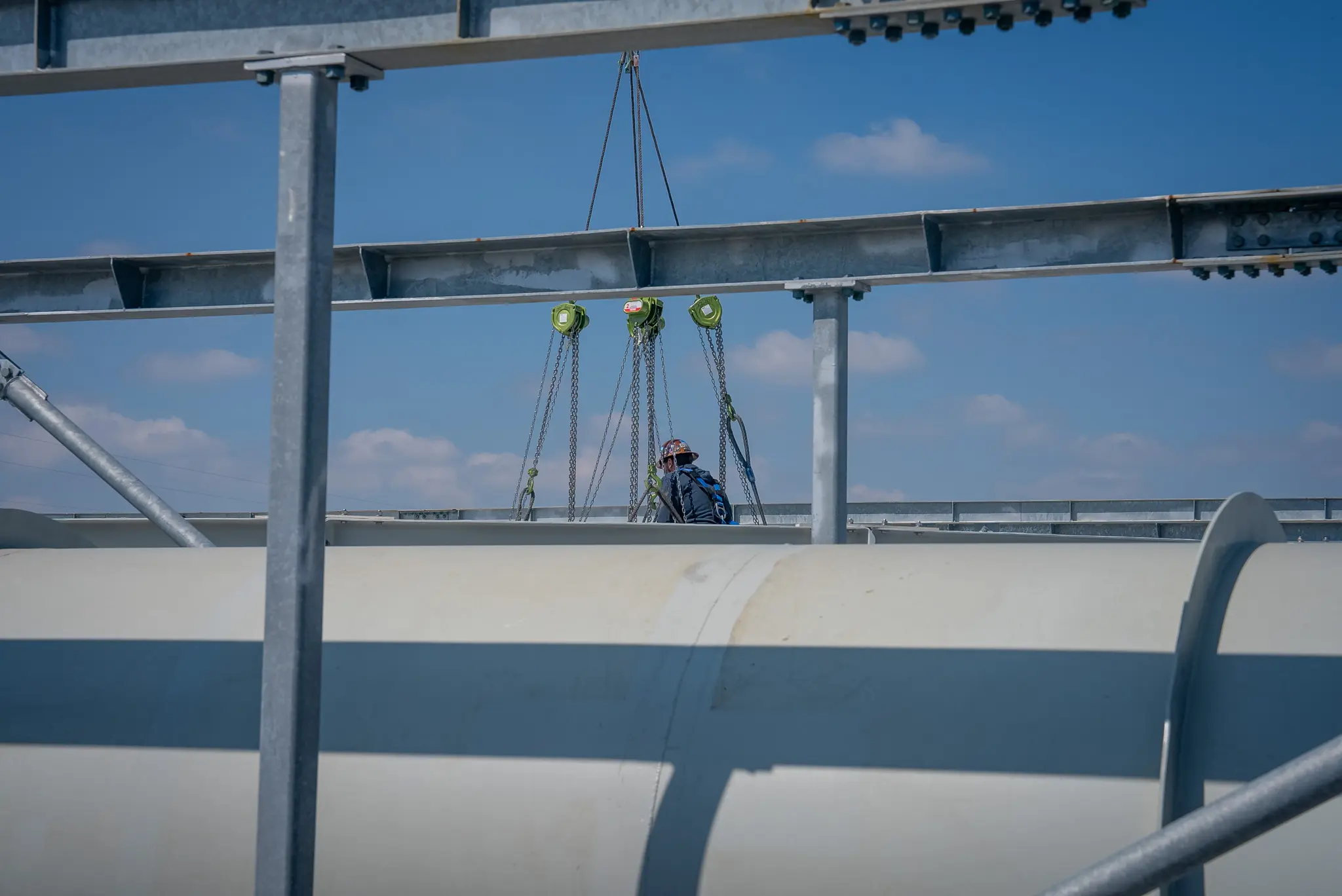

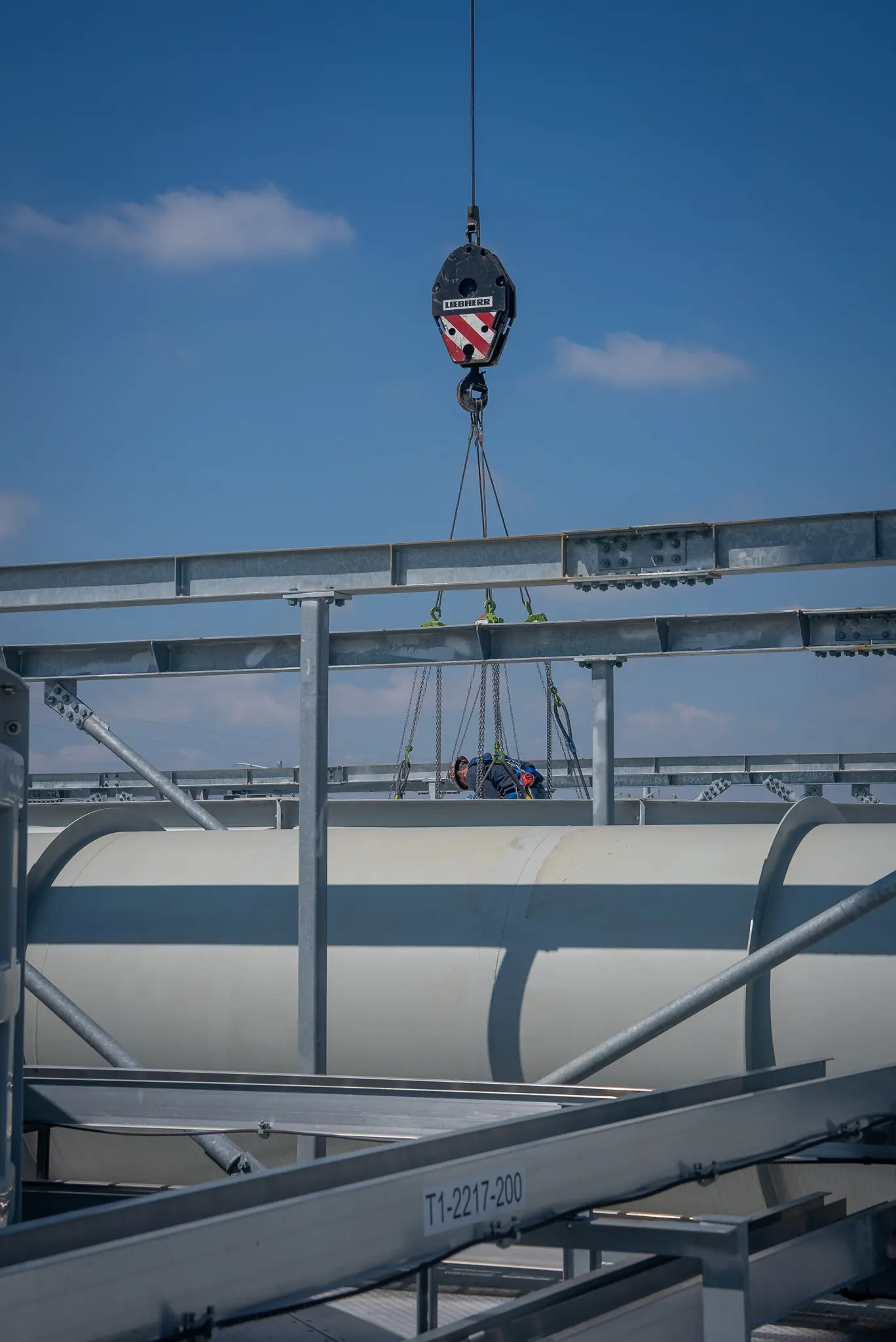

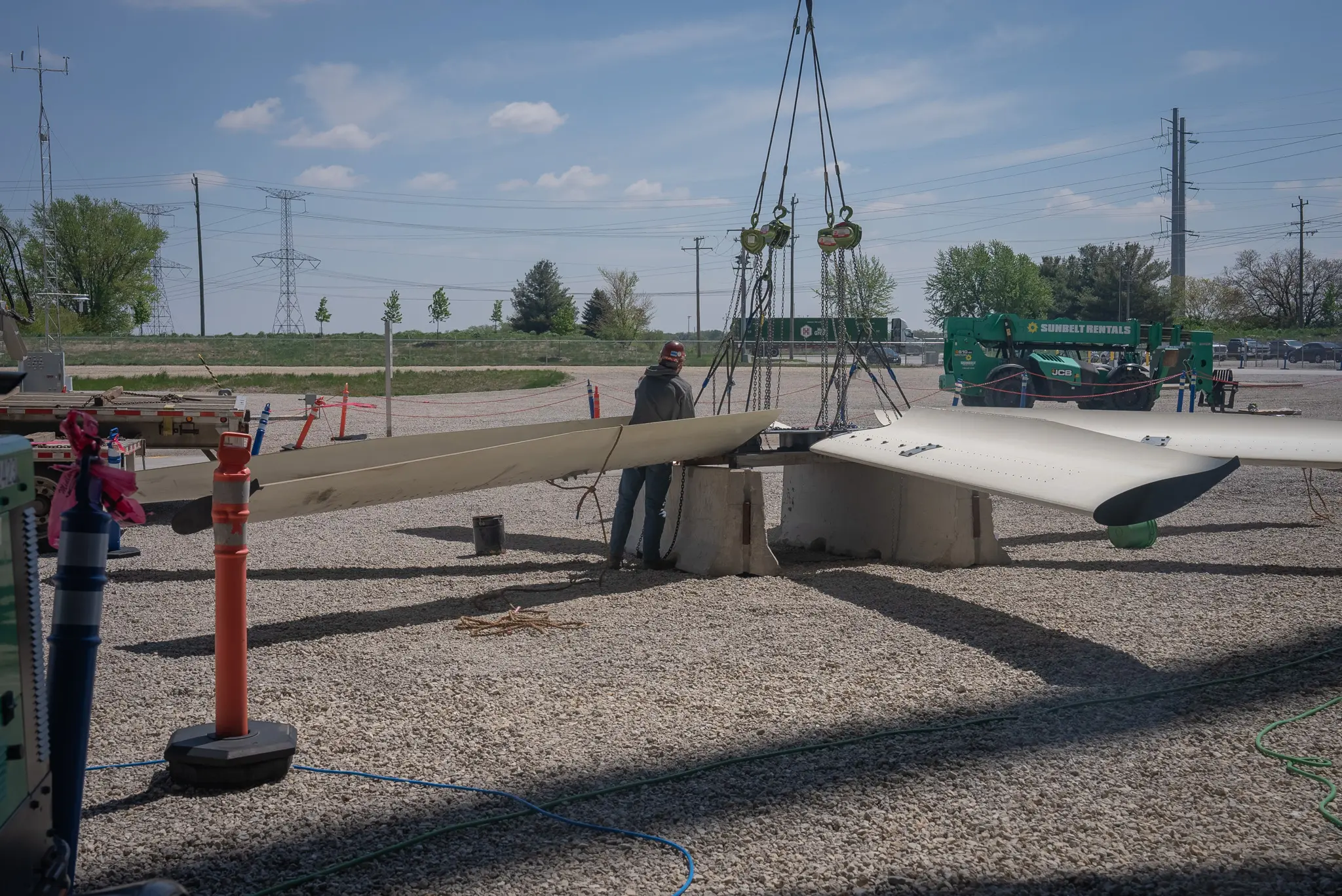

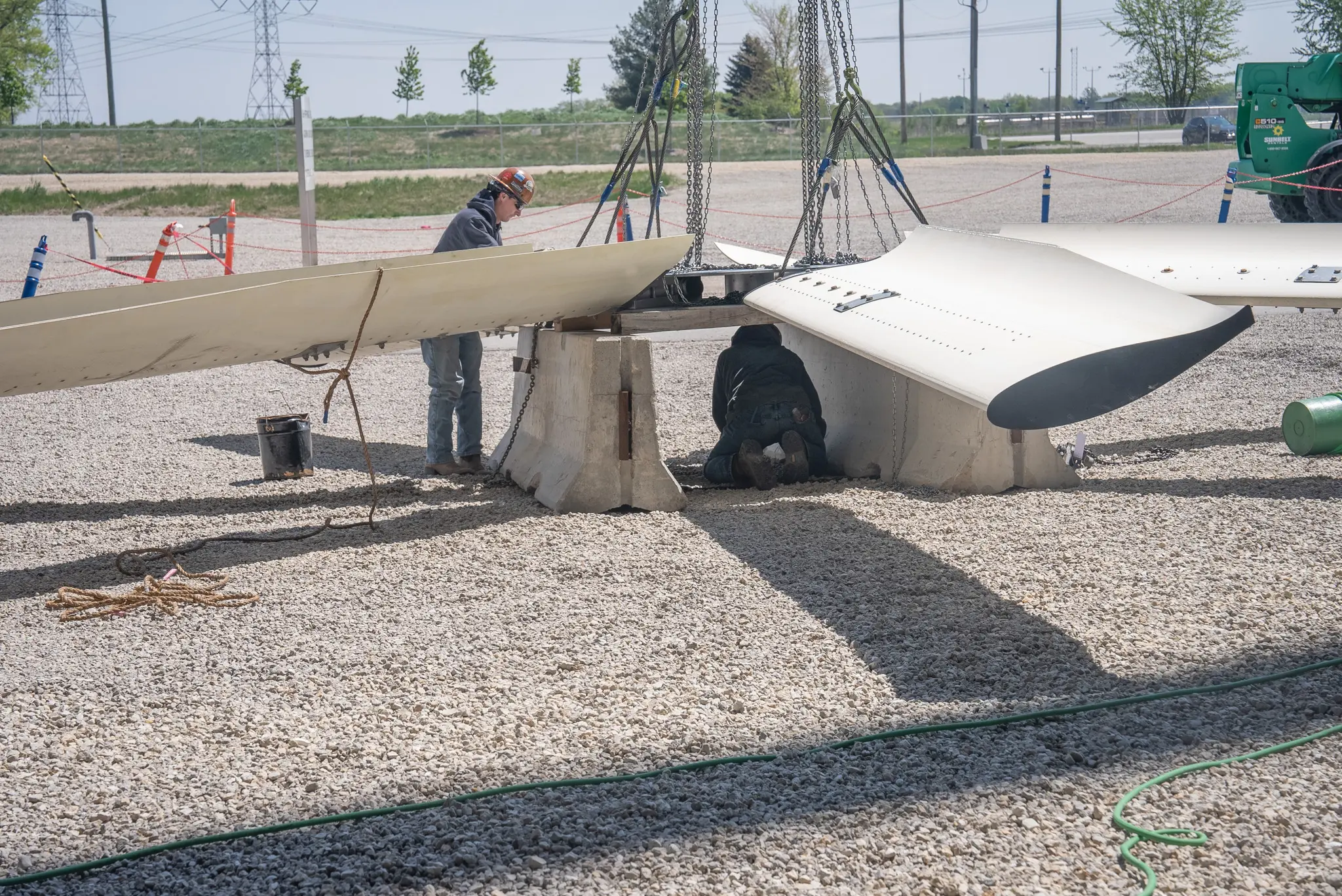

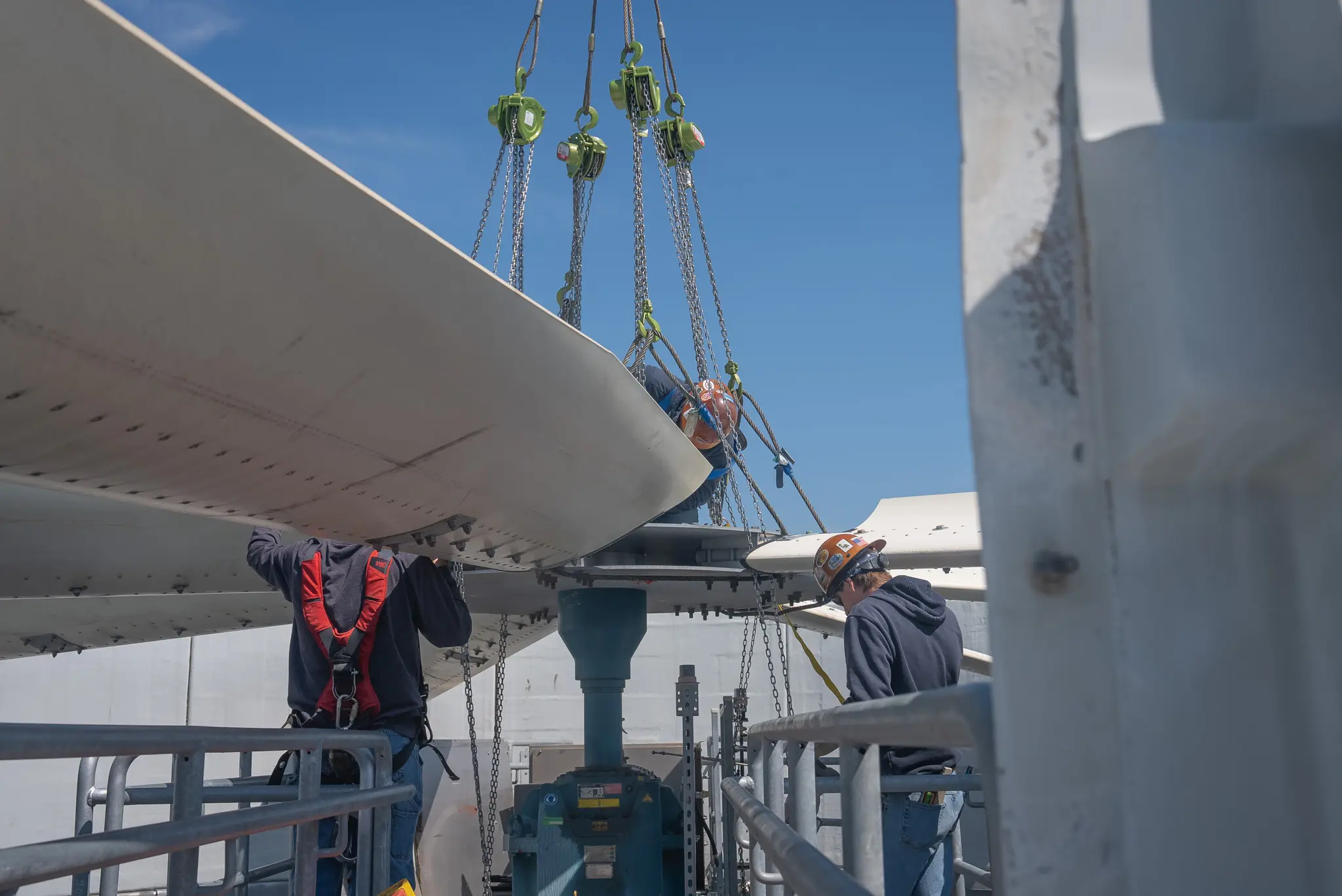

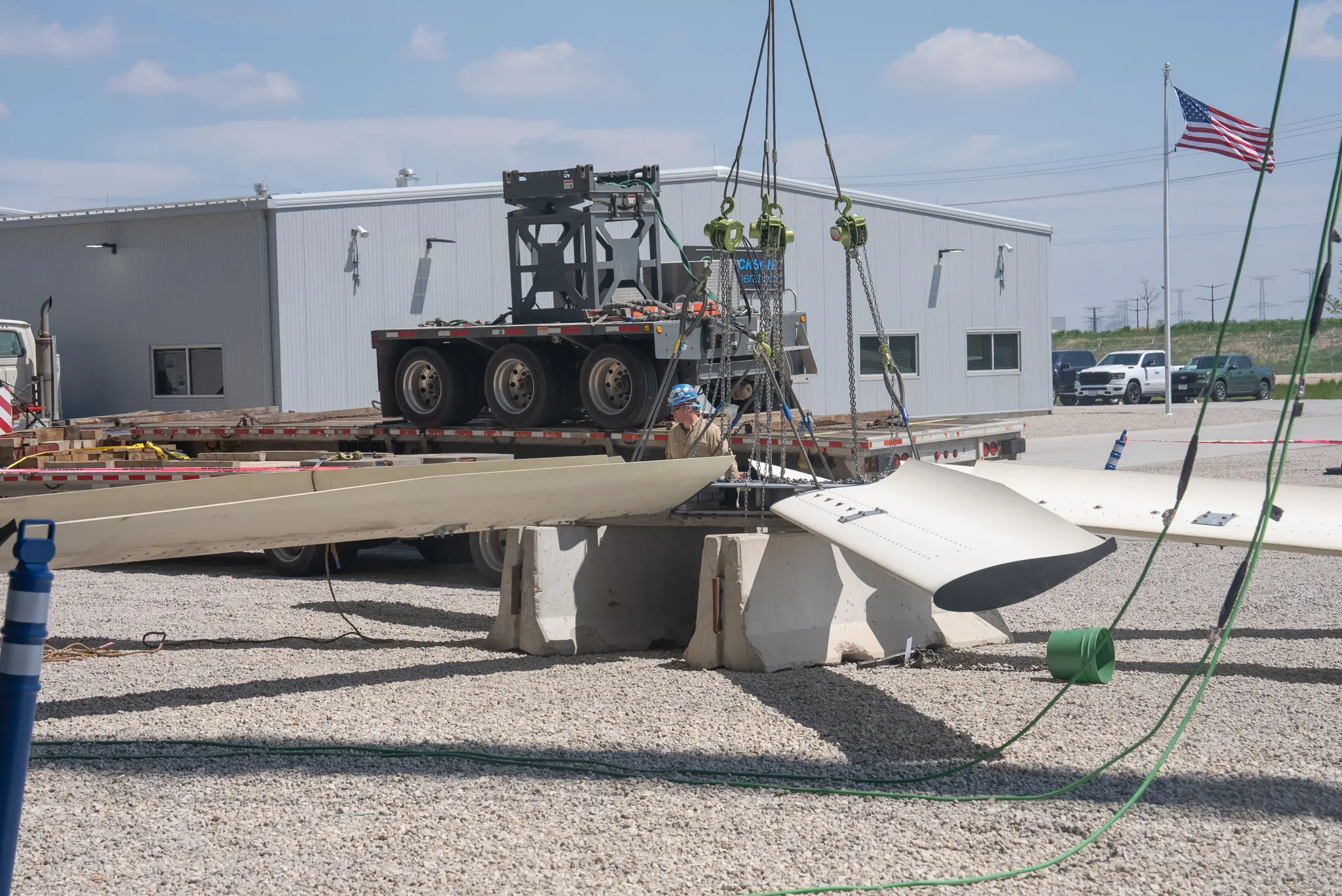

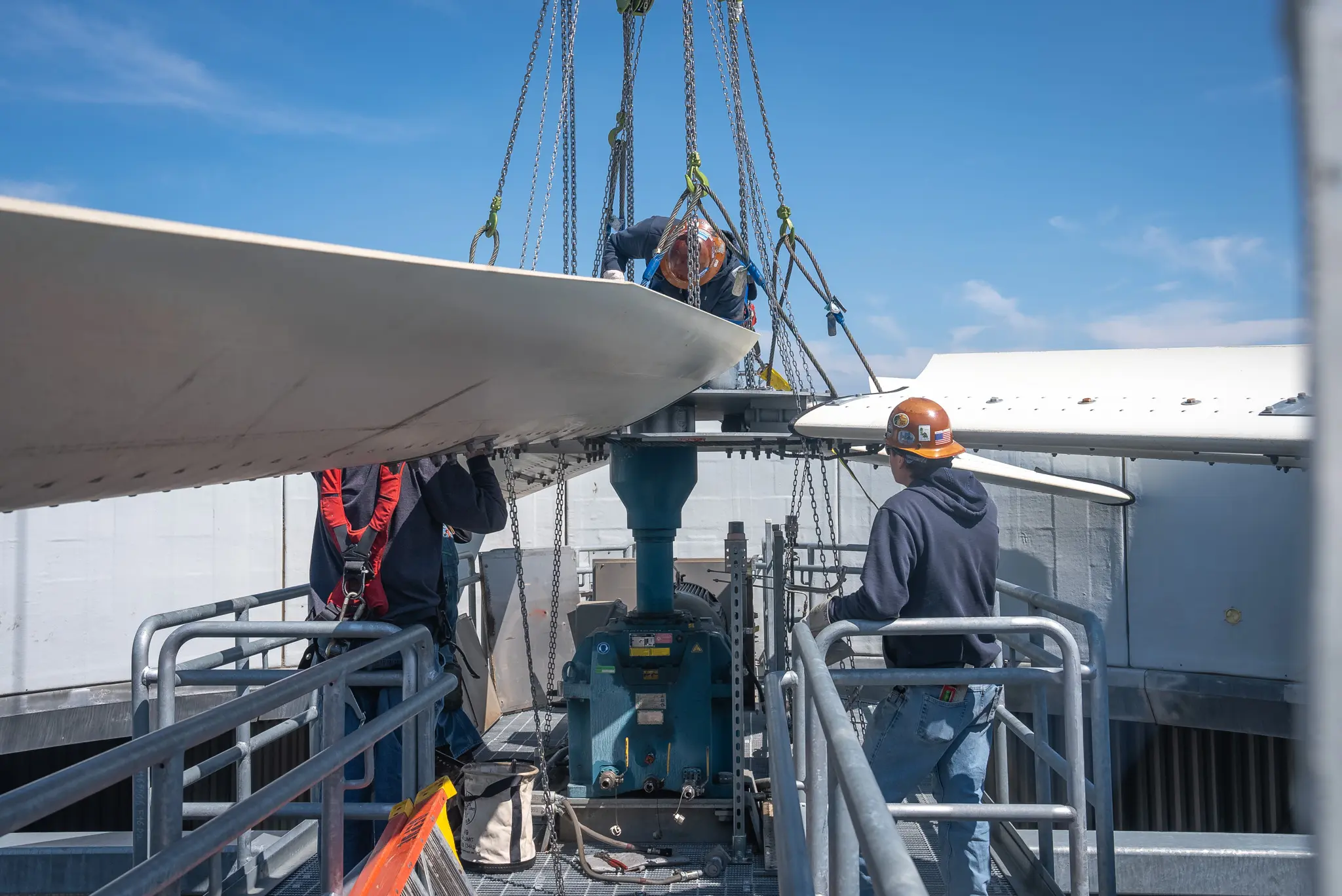

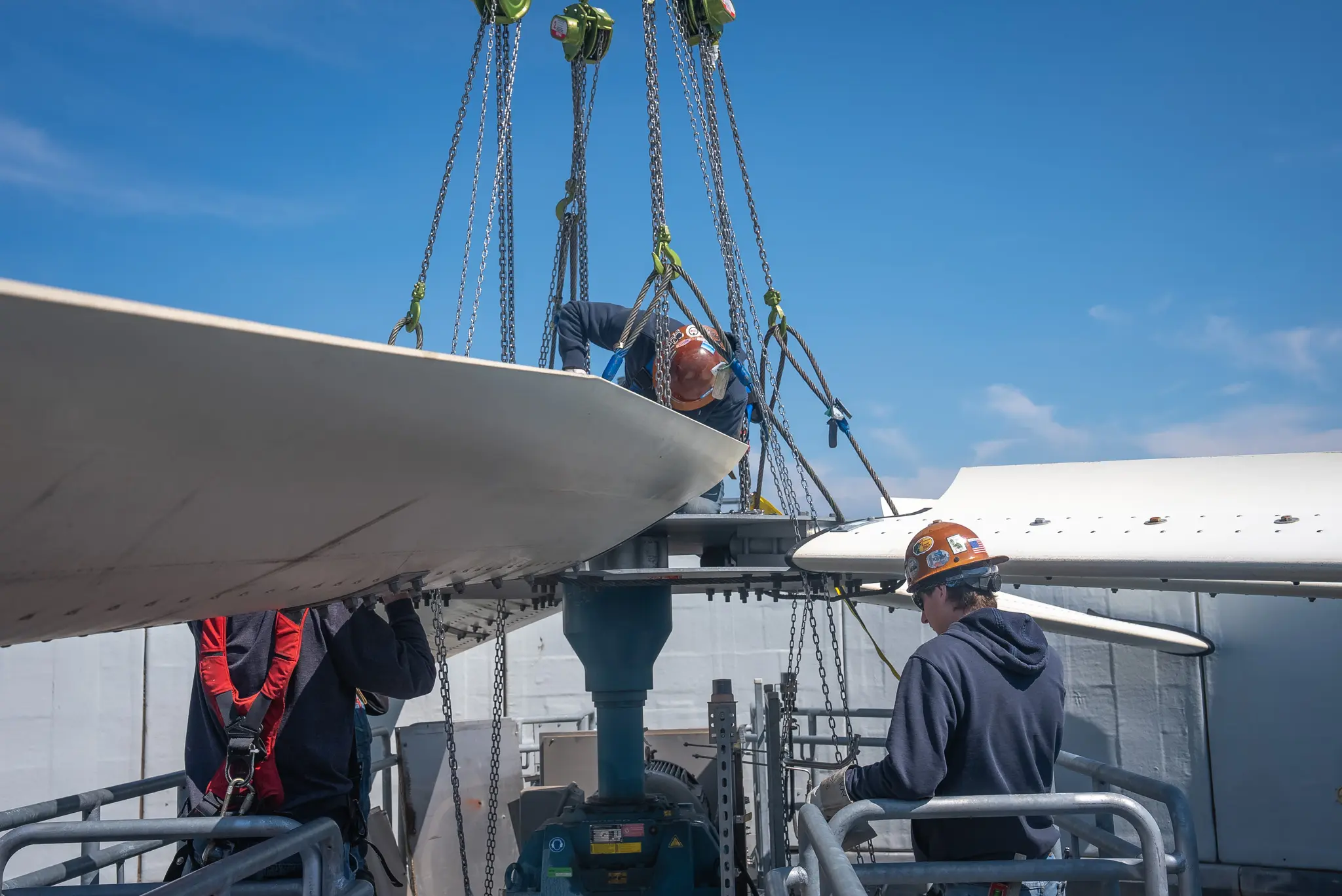

For each replacement, the crew disconnected the approximately 4,200-pound fan assembly and lowered it using a 125-ton crane. The gearbox shaft was uncoupled from the motor, and the approximately 5,200-pound gearbox was then lowered to the deck.

The crew unsweated the fan blade couplings from the existing equipment and re-sweated them onto the replacement gearboxes. The new gearboxes and fan assemblies were then lifted back into position for coupling and reassembly.

This sequence required coordination among the crane operator, rigging personnel, millwrights, and mechanical crews. Lift timing, equipment orientation, access, coupling work, and reassembly all had to be controlled so each gearbox could move through the replacement sequence without delaying the other planned outage work.

While the gearbox changeouts were underway, DePue also drained and refilled the oil in 48 ACC gearboxes. Performing this maintenance in parallel helped the plant use the outage window for both major equipment replacement and broader preventive service.

Code-Sensitive Valve Welding

9-Chrome Valve Replacement with Radiography and PWHT


DePue completed the code-sensitive welding required to cut out and install a new 2-inch 9-chrome valve as part of the outage scope.



The welds were examined through a four-step radiographic testing sequence:



  • Two radiographs before post-weld heat treatment

  • Post-weld heat treatment

  • Two additional radiographs after heat treatment

  • Follow-up crack testing after completion of PWHT




The inspection sequence had to be incorporated into the outage schedule so welding, radiography, heat treatment, and final examination could proceed without creating an avoidable critical-path delay.



DePue also replaced a 1/2-inch socket-weld valve in the gas yard and cut out and welded two new 1/2-inch valves on the Unit 1 condenser B strainer vent lines.



Pressure piping and pressure-retaining system welding requires more than field welding alone. Material requirements, qualified procedures, inspection hold points, heat treatment, examination, and documentation all have to be understood before the system is released for return to service.

Valve and Instrumentation Work

Thermowell, O-Let, Gasket, and Small-Bore Piping Repairs

The outage included several smaller repairs that were individually important to system reliability and inspection readiness.

DePue installed a new 3/4-inch stainless steel o-let and thermowell on the reverse osmosis water system. The crew also replaced a failed thermowell on the Unit 1 intermediate-pressure turbine.

On the Unit 1 condenser strainer, DePue replaced a leaking 48-inch gasket. The size of the connection required controlled disassembly, gasket placement, flange alignment, and reassembly to restore the joint.

These tasks were coordinated alongside the larger gearbox, valve, vessel, and ACC scopes rather than being treated as separate projects.

Confined-Space Repairs

Vessel Entries, Drum Work, and Internal ACC Welding

Multiple portions of the outage required controlled confined-space entries.

DePue entered the Unit 1 and Unit 2 high-pressure, intermediate-pressure, and low-pressure vessels to install screens on the vortex piping. Crews also entered the HP drums on both units to install new mesh and clips.

One of the most labor-intensive portions of the scope took place inside the ACC system. DePue personnel entered a 48-inch pipe and completed the industrial field welding required to install 144 plates and abandon leaking tubes. Crews worked around the clock to advance the internal welding scope within the outage schedule.

Confined-space work during an outage requires careful coordination of entry controls, atmospheric monitoring, ventilation, communications, hot-work requirements, personnel access, material handling, and rescue planning. These controls had to remain in place while the repair crews maintained the production rate required by the schedule.

HRSG, Expansion Joint, and Leak Repairs

Resolving Mechanical Deficiencies Identified for the Outage

DePue replaced a drain on the Unit 2 heat recovery steam generator that had split during cold weather.

The crew also repaired a leak at a fitting on the Unit 2 lube oil accumulator and replaced a 24-inch expansion joint on Unit 2.

These repairs addressed different systems, materials, access conditions, and failure modes. Completing them within the same outage required flexible manpower, coordinated industrial maintenance support, and communication with plant personnel responsible for system isolation, access, inspection, and turnover.

SCR Blower Valve Replacement

Removal and Installation of a 16-Inch Butterfly Valve

DePue removed the existing valve and installed a new 16-inch butterfly valve on the Unit 2 selective catalytic reduction blower system.

The work required handling and positioning a large valve within the available access, aligning the replacement with the existing system, and completing the installation within the outage sequence.

Who We Are

We Listen

The client established a May 3 through May 17 shutdown window and presented DePue with a multi-trade scope across Units 1 and 2.

The plant needed gearbox replacements, crane work, ACC maintenance, specialty valve welding, radiography, PWHT, confined-space repairs, drum work, instrumentation connections, leak repairs, and large-valve replacements completed within one coordinated outage.

Who We Are

We Respond

DePue organized the work into parallel shutdown and turnaround work fronts.
Crews replaced four gearboxes with a 125-ton crane while oil service was completed on 48 additional ACC gearboxes. Other teams advanced valve welding, thermowell installations, gasket replacement, drum door work, HRSG repairs, expansion joint replacement, vessel entries, and SCR blower valve replacement.

Radiography and post-weld heat treatment were incorporated into the 9-chrome valve welding sequence. Confined-space teams worked inside vessels, drums, and 48-inch ACC piping, including round-the-clock welding of 144 tube-abandonment plates.

Who We Are

We Deliver

DePue executed the assigned mechanical scope within the scheduled outage window.

Crane operations, rotating-equipment replacement, confined-space entries, valve and piping work, radiographic examination, post-weld heat treatment, machining, and internal ACC repairs were coordinated toward a clean mechanical handoff at the end of the shutdown.

For the plant team, the result was one contractor managing a broad range of mechanical repairs without separating the work into disconnected scopes.

Project Proof

Mechanical Outage Support for Power Generation Facilities

Power plant outages regularly combine planned maintenance, inspection findings, equipment replacement, emergent repairs, code-sensitive welding, confined-space access, and work that cannot begin until systems are isolated.

The mechanical contractor has to understand more than the individual repair procedure. The contractor must also understand the outage schedule, critical-path activities, lift restrictions, inspection hold points, system turnover sequence, simultaneous operations, and the consequences of missing the return-to-service window.

DePue Mechanical supports plant managers, maintenance managers, facility engineers, operations teams, and outage planners with industrial maintenance crews, qualified welding capabilities, rigging coordination, piping work, equipment replacement, and field execution built around actual plant conditions.

power generation services.

Connect With Us

Planning a Power Plant Outage or Fixed-Window Mechanical Shutdown?

DePue Mechanical supports power generation facilities and industrial plants with planned outage and shutdown work, equipment replacement, heavy lifts, pressure piping repairs, valve replacement, code-sensitive welding, confined-space repairs, HRSG work, expansion joints, instrumentation connections, and emergency mechanical repairs.

Send DePue your outage schedule, equipment list, inspection findings, drawings, photographs, material requirements, crane constraints, confined-space scope, and expected testing requirements. Our team can help review the work, identify coordination needs, and build an execution plan around the available outage window.

Schedule a Planning Call
Schedule a Walkthrough

Project FAQ

FAQs About Power Plant Outage Mechanical Repairs

What work did DePue Mechanical complete during the Jackson Generation outage?
DePue replaced four ACC gearboxes, serviced 48 additional gearboxes, replaced valves and thermowells, completed 9-chrome valve welding with radiographic testing and PWHT, performed confined-space vessel and drum work, welded 144 tube-abandonment plates, repaired leaks, replaced a 24-inch expansion joint, and installed a 16-inch SCR blower butterfly valve.

How were the ACC gearboxes replaced?
DePue used a 125-ton crane to lower the approximately 4,200-pound fan assemblies and 5,200-pound gearboxes. The couplings were transferred to the replacement gearboxes before the new equipment and fan assemblies were lifted back into position and reassembled.

What inspection was performed on the 9-chrome valve welds?
The 2-inch 9-chrome valve replacement received four radiographic examinations. Two were performed before post-weld heat treatment and two after heat treatment. Follow-up crack testing was also performed after PWHT. Learn more about DePue’s ASME code welding capabilities.

Did the project include confined-space welding?
Yes. DePue completed controlled entries into HP, IP, and LP vessels, HP drums, and 48-inch ACC piping. The internal ACC scope included welding 144 plates to abandon leaking tubes.

Can DePue support power plant shutdowns involving several types of mechanical work?
Yes. DePue can coordinate planned shutdown and turnaround scopes involving piping, valve replacement, code-sensitive welding, equipment setting, crane lifts, confined-space repairs, pressure-system work, leak repairs, instrumentation connections, and other industrial mechanical tasks.

Project Gallery See the project
